July 2026
Tunneling has started near North Tryon Street and Pavilion Boulevard. Tunneling will take approximately 6-8 months.
June 2026
Crews started pipe-laying activities at the Mallard Creek Water Reclamation Facility and along the Pavilion Boulevard/I-485 corridor. Tunneling activities are expected to begin soon in the Pavilion Boulevard and North Tryon area.

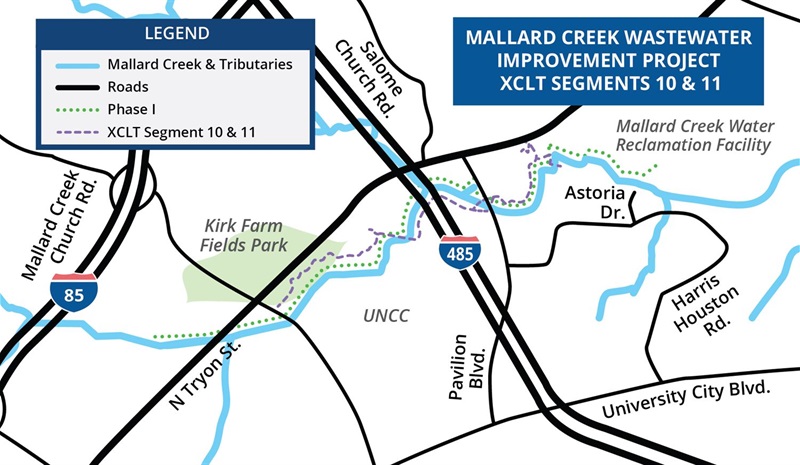

The Mallard Creek Wastewater Improvement Project is a multi-phase sewer improvement project that will extend from Mallard Creek Water Reclamation Facility (WRF), follow Mallard Creek upstream across the basin and end at the West Mallard Branch. Phase I will extend from the Mallard WRF to the west side of North Tryon Street. Phase II will extend from North Tryon Street to Mallard Creek Road.
